The way they've built the roads seems like they are planning contingencies if they need more exits (or possibly entrances). The plan may be for all traffic to use the new exit but have backup exits they can open if needed.

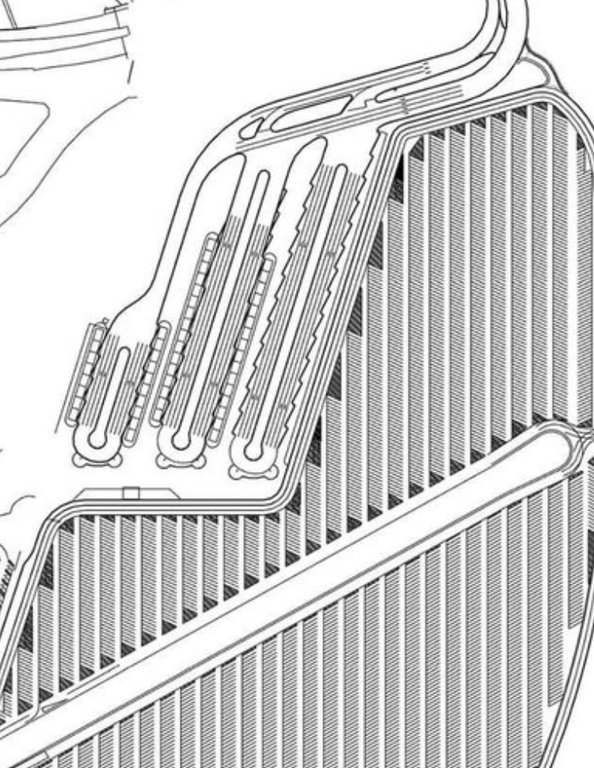

View attachment 293602
I would agree. As it shapes up it looks like options are being kept open. Where is this drawing from?

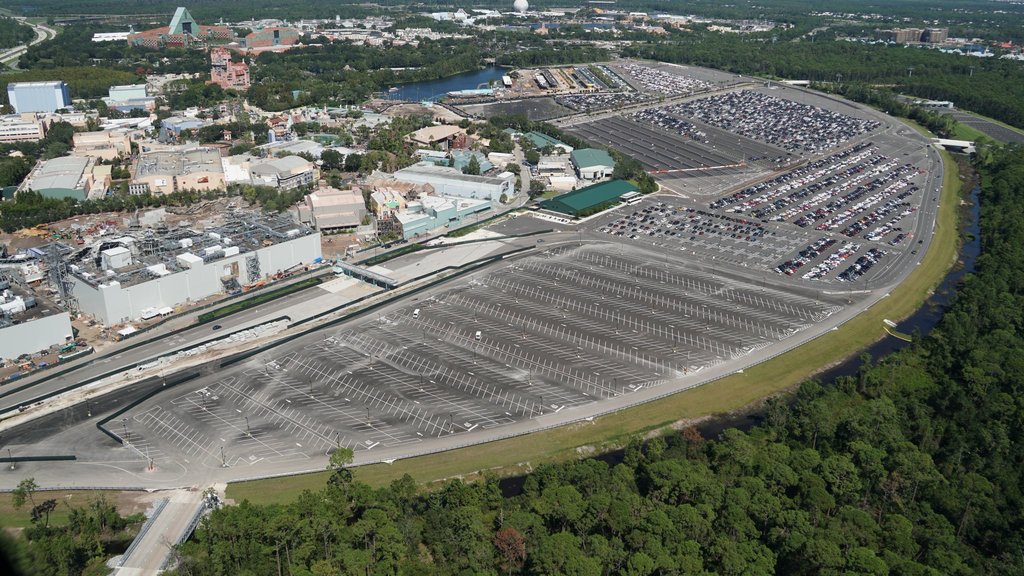

I know this discussion started earlier above regarding whether or not the Buena Vista Dr entrance/exit would go bus only or would remain for guest cars too. Obviously not having an exit onto Victory Way could be mitigated if an exit onto Buena Vista Dr would remain. I was looking at some @bioreconstruct aerials from the last two months and noted that some of the work may be evidence that at least an exit to Buena Vista Dr would remain. First image is under construction and the second more complete.
Blue box= Area of possible exit with curbing placed; yellow circles = curb drains placed (this is evidence of permanent infrastructure, running drainage and curb drains isn't a temporary kind of fix); red circles=areas with no curbing yet, probably eventually reconfigured
View attachment 292877View attachment 292878
Did a quick and obviously dirty drawing of a possible final configuration of the area. No insider info, but just a compilation of what is being built and what has been suggested. I see no guest entry here, but only guest exit. If anyone has info that can edit to improve, much appreciated. Just trying to imagine it all.
View attachment 292879
I wonder what the new dates are? The most recent pictures conflict with the expected dates.I found the bid documents for this project which include the expected completion dates:
6/15/2018 - Limited access to the new DHS entrance
9/1/2018 - Full access to the new DHS entrance
12/17/2018 - Most work done on the Victory/Osceola portion of the project
11/1/2019 - Work complete on the World Dr portion of the project.
the plans also mention that the existing entrance to DHS will be closed permanently.
I wonder what the new dates are? The most recent pictures conflict with the expected dates.
That said, I do think its possible that they could get all of the new DHS entrance access roads linked up with Osceola by the end of the year - even without the Osceola/Victory flyover done.
True. I guess one insight from them, though, is that there was anticipated to be a 3 month period between "limited" access to the new DHS entrance and "full" access. There's obviously no access now so I guess it's possible that they'd open the Osceola westbound and Victory southbound entrances and the Osceola westbound exit before the others? Maybe that's what they have in mind for November?These dates were from the bid document so they may never have been what was finally agreed to.
figured this should be posted here
New aerial from bioreconstruct today:
It does look like they're working on the getting the DHS exit to Osceola eastbound finished and connected so that it could open before the flyover is done.
I'm also intrigued by the fact that they have a temporary construction "road" from the exit loop to Victory Way. It's not in any of the plans published but it does point to the possibility of there being a left-hand exit off the loop onto Victory Way. It's also not clear whether the current dirt road from the electrical substation to Victory Way would remain open, creating a (limited) exit from DHS to Victory Way southbound.
At least one option to exit via city streets would be good.And looks like they will not be doing the phased opening of the ramps into DHS. All the ramps will open at once and then they will just have the flyovers over Victory Way on Osceola. That is definitely temporary construction road which will be going away. I don't think there will be a Victory Way exit, however I think there will be an exit only onto Buena Vista Dr.
New aerial from bioreconstruct today:
It does look like they're working on the getting the DHS exit to Osceola eastbound finished and connected so that it could open before the flyover is done.
I'm also intrigued by the fact that they have a temporary construction "road" from the exit loop to Victory Way. It's not in any of the plans published but it does point to the possibility of there being a left-hand exit off the loop onto Victory Way. It's also not clear whether the current dirt road from the electrical substation to Victory Way would remain open, creating a (limited) exit from DHS to Victory Way southbound.
And looks like they will not be doing the phased opening of the ramps into DHS. All the ramps will open at once and then they will just have the flyovers over Victory Way on Osceola. That is definitely temporary construction road which will be going away. I don't think there will be a Victory Way exit, however I think there will be an exit only onto Buena Vista Dr.
